Planning


On this page you will find information to guide your planning activities for the MHHS Programme.


Baselined MHHS Implementation Timeline

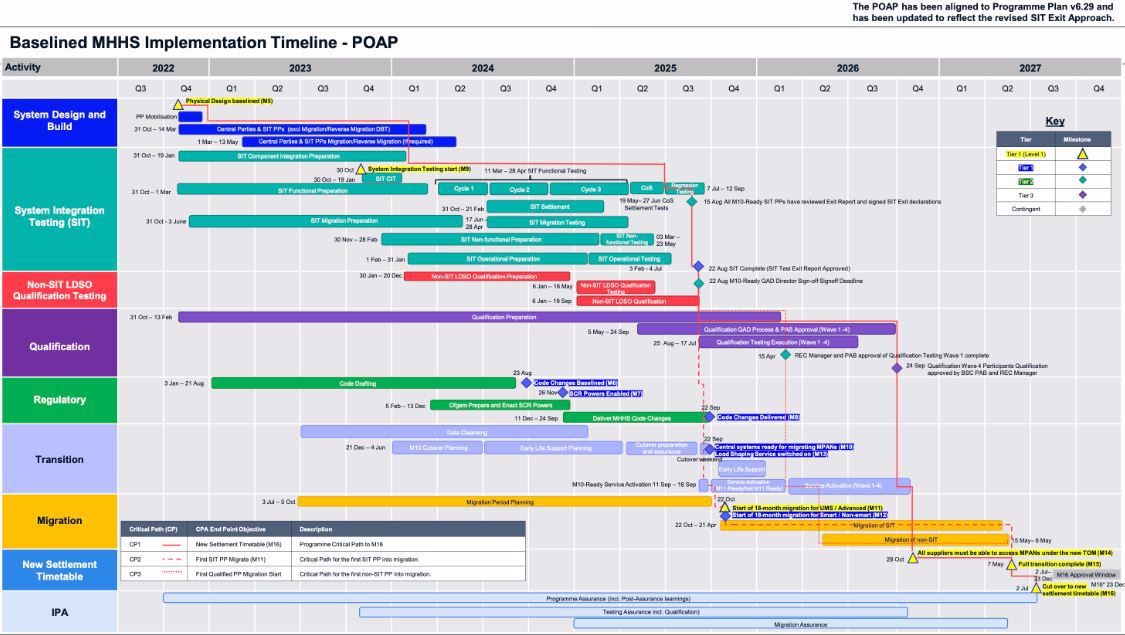

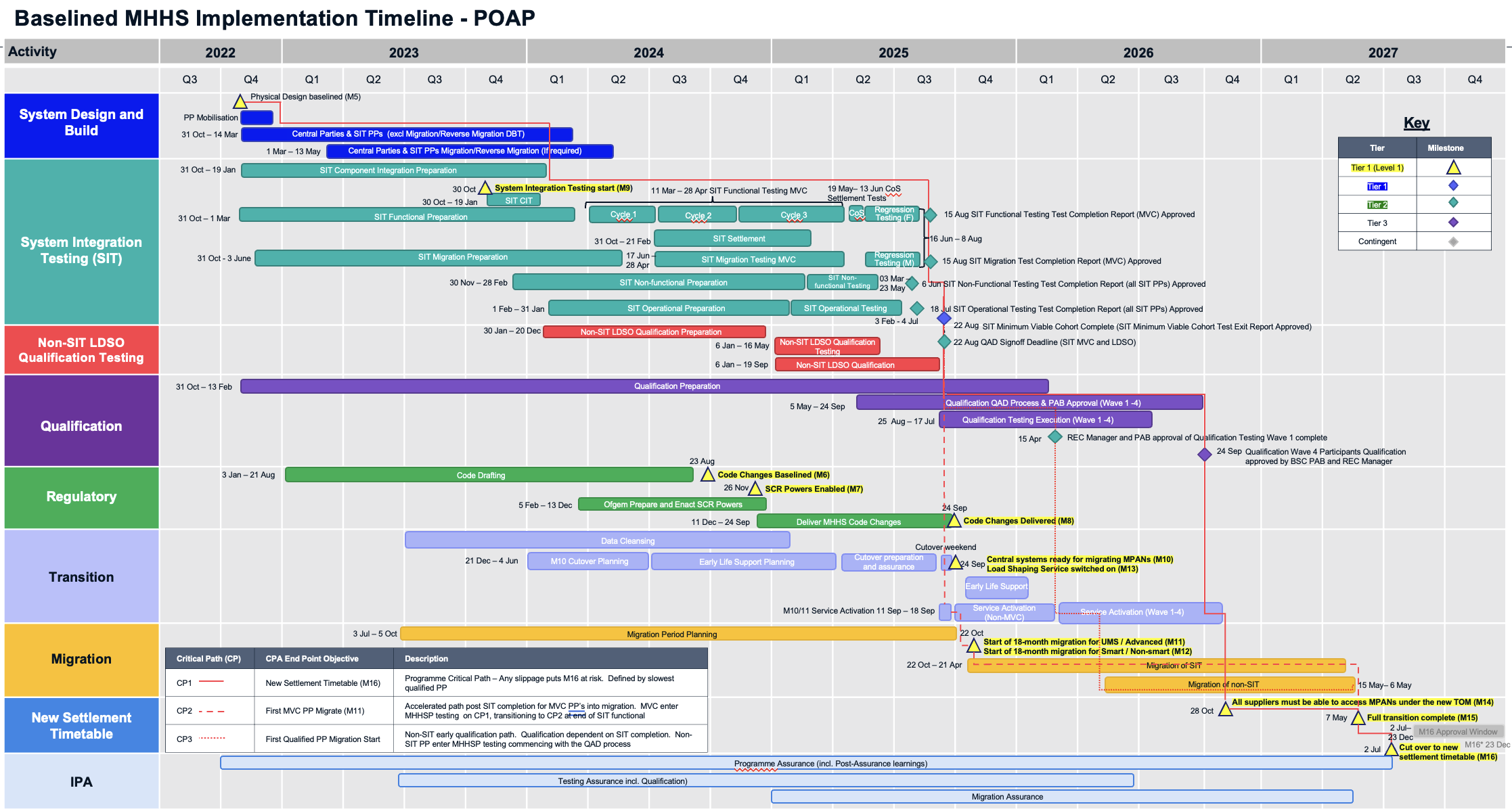

The below Plan on a page (Poap) is the MHHS Implementation Timeline, as of 24 July 2025, that articulates the delivery stages of the Programme. Click on the image below to open an enlarged version.

The Poap has been aligned to Programme Plan v6.29 and has been updated to include further detail.

You can find more information on the Baselined Plan, Milestone Register and Implementation Approach on the Programme Plan & Complementary Documents page of this website.


Key information to support your navigation of the Programme

Which deliverables are out for review and what are key dates that I need to be aware of?

The Participant Checklist is a checklist to keep Programme participants up to date with Programme requests for review and engagement.

You can view the checklist below:

Participant Checklist



What are the Programme governance meetings that I need to attend and where can I find information on them?

Visit the Events page of this website



Where can I find information on the Critical Path my organisation is on regarding Testing and Qualification responsibilities?

If you have any questions, or would like further information on this, please email PMO@mhhsprogramme.co.uk
